Belmont Area, Ayr

We’re carrying out safety-critical work to upgrade our gas network in the Belmont area of Ayr.

In agreement with South Ayrshire Council our project will start on Monday 14 June 2021 and last approximately 46 weeks.

By upgrading our gas network in the Belmont area, we’ll continue to keep Ayr homes and businesses safe and warm long into the future.



Update 23 December 2021

We’ve almost completed stage four of our project, and are ready to start stage five in the new year.

Whilst most of our work will be carried out on the carriageway and footpaths with give and take traffic management in place, there will be times where more extensive traffic management measures will be required as set out below.

During stage five, we’ll be working in the following areas:

From now until 31 January, we’ll continue working in Knoll Park

From 4 January, we’ll be working in Monument Road as follows:

  • Junction with Ewanfield Road and Chapelpark Road, where we’ll install temporary four-way traffic lights which will be in place for approximately two weeks
  • Junction with Longbank Road, where we’ll install temporary three-way traffic lights for approx one week
  • Junction with Longlands Park, where we’ll install temporary three-way traffic lights for approx one week
  • We’ll then use temporary two-way traffic lights along the route where required, while we continue our work on Monument Road

From 23 Jan to 28 March, we’ll be working in the following areas:

  • Linfern Place
  • Milton Park
  • Gower Place
  • Finlas Avenue



Update 28 October

We’ve now completed up to stage three of our project, and are now ready to start stage four. Whilst most of our work in this fourth phase will be carried out on the carriageway and footpaths with give and take traffic management in place, there will be phases of this project where more extensive traffic management measures will be required. The following is a weekly guide on where will be and any restrictions which will be in place:

w/c 01/11/21

  • Taybank Drive
  • Maybole Road – during this phase, we’ll be installing temporary three-way lights on Maybole Road at its junction with Laughlanglen Road

w/c 08/11/21

  • Taybank Drive
  • Maybole Road with temporary three-way traffic lights as before

w/c 15/11/21

  • Sunningdale Drive and Longlangs Park
  • Maybole Road with temporary three-way traffic lights as before

w/c 22/11/21

  • Knoll Park
  • Milton Park
  • Gower Place
  • Maybole Road with temporary three-way traffic lights as before

w/c 29/11/21

  • Monument Road – during this phase, we’ll be installing temporary four-way traffic lights on Monument Road at its juction with Ewanfeild Road and Chapelpark Road
  • Finlas Avenue

w/c 06/12/21

  • Finlas Avenue
  • Linferne Place

w/c 13/12/21

  • Gower Place
  • Finlas Place
  • Milton Park





Update 3 September

For everyone's safety, we need to close Belmont Avenue, between its junctions with Belmont Road and Belmont Drive. Local signed diversions will be in place via Belmont Road, Meadowpark and Belmont Drive.

This closure will take place from Monday 6 September until no later than end of the working day on Friday 10 September.


Update 18 August

Phase two – approx. six weeks

The second phase of this project started on 16 August 2021.

The temporary traffic lights at the roundabout on Dalmellington Road have now been removed and access to Belmont Road is now available from Dalmellington Road is and Maybole Road/St Leonards.

During this next stage, we’ll be working in the following areas:

  • Maybole Road, between numbers 1 and 23. Whilst we carry out our work in Maybole Road, it may be necessary to install temporary two and three-way traffic lights.
  • Nursery Road
  • Fenwickland Avenue, from Belmont Road to Peggieshill Road (behind school)
  • Belmont Avenue, from Belmont Road to opposite No 59/61
  • Longbank Road
  • Longbank Drive
  • Shawfield Avenue

Unless otherwise stated, all of our work in phase two will be carried out in the carriageway and in footpaths with minimal disruption.


Phase one – approx. 10 weeks


The first phase of this project will begin on Monday 14 June; we’ll install temporary two-way traffic lights on Dalmellington Road, between Forest Way and Belmont Road, for around two weeks. We’ll also be working in Ewenfield Road, Ewenfield Park and Ewenfield Place.

From Saturday 26 June, we’ll begin working in Belmont Road. To ensure everyone’s safety, we’ll be closing Belmont Road at both ends (at its junctions with Maybole Road and Dalmellington Road). We’ll also need to install temporary three-way traffic lights at these junctions.

While Belmont Road is closed, our teams will progress along it and then into Nursery Road and Peggieshill Road. They will also be working in Maybole Road, between its junction with Belmont Road and the Kwik Fit garage, and in Fenwickland Drive between Belmont Road and Peggieshill Road.

On Saturday 10 July, we’ll reopen Belmont Road at the Dalmellington Road end for local access. We’ll also remove the temporary three-way traffic lights at this end. However, the road closure and temporary lights at Belmont Road’s junction with Maybole Road, will remain in place until around Saturday 21 August.

You can see this first phase highlighted in yellow on the map below. Details for work in the streets highlighted in blue are yet to be finalised.

All phases and durations may be subject to change as the project develops, but we’ll keep you updated with our progress right here.

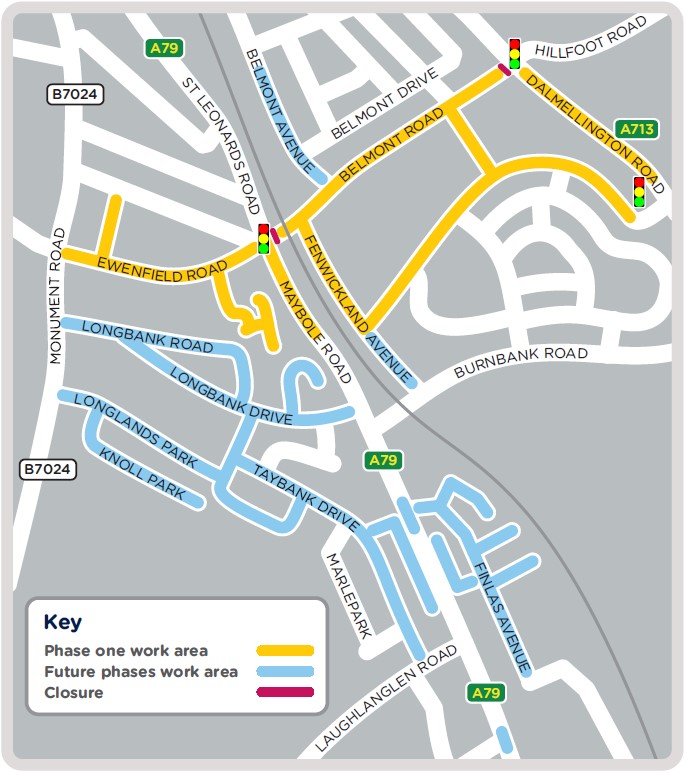

Media library image
A map depicting where we're working in the Belmont area of Ayr
